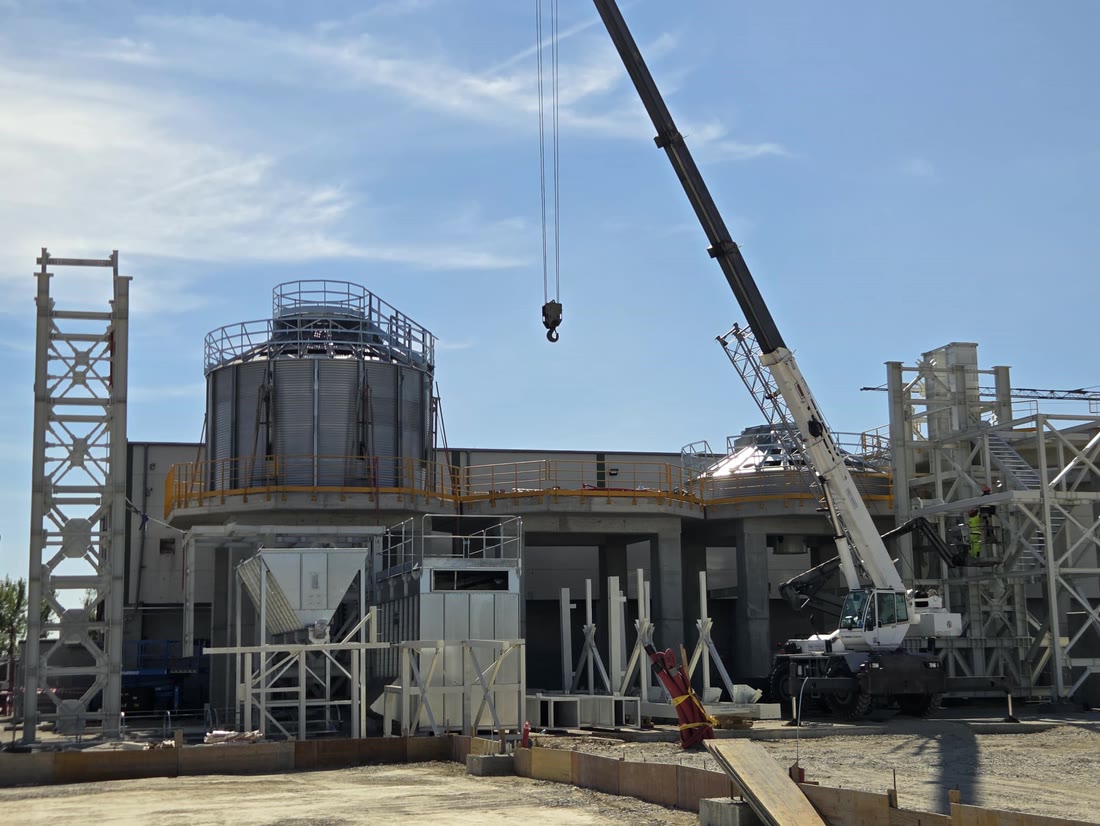

Mulmix pellet silo mounted on a raised concrete platform at the Biotim plant in Timișoara, with a telescopic crane on site

Timișoara, Timiș county · 2,000 t · Biomass and pellets

2,000-tonne pellet silos at Biotim Timișoara

We have started assembling the 2,000-tonne pellet silos, with Mulmix equipment, at the Biotim biomass plant in Timișoara. How a silo goes up, ring by ring.

Location
Timișoara, Timiș county, Romania
Capacity
2,000 t
Type of work
Silo mechanical assembly
Technology
Biomass and pellets
Year
2026

Published

We have started the mechanical assembly of the pellet silos at Biotim Timișoara, Romania's future largest biomass pellet plant. Storage capacity: 2,000 tonnes. The equipment comes from Mulmix.

This is our second job on the site. In May we were assembling the Cormall straw debaling line, and we said then that we would report back as the site progressed.

Mulmix pellet silo mounted on a raised concrete platform at the Biotim plant in Timișoara, with a telescopic crane on site

The other end of the process line

The debaling line is the entry point: straw bales are opened there and the fibre moves on to grinding, conditioning and pelletising. The silos are the exit. The finished pellets end up in them, and leave from there to the customer.

These are two distinct jobs, with equipment from different suppliers and assembly methods that have little in common. What stays the same is the site and the crew.

Mulmix silos on a raised concrete platform

The silos do not sit on a ground slab. They are mounted on a concrete platform carried on columns, with a loading bay left clear underneath for the truck to pull into.

There is a practical reason for this. The pellets come down from the cell by gravity, straight into the truck. No extra conveyor, no double handling, no machine shuttling the load from silo to weighbridge. In a plant sized for large volumes, the time it takes to load one truck is a cost that adds up every single day.

For us, the height changes how the work is done. Assembly happens at level, with the material lifted onto the platform and every check carried out up there.

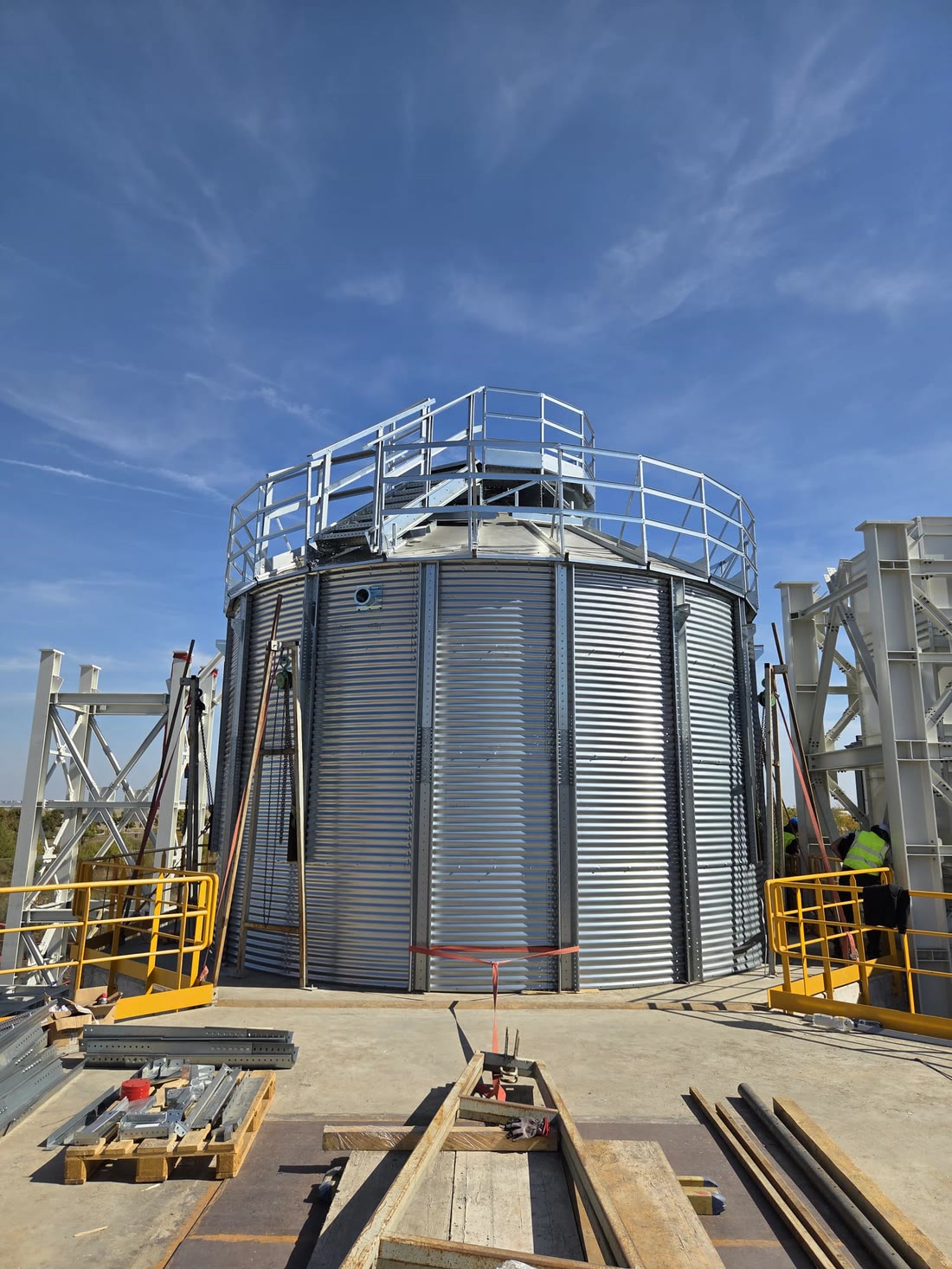

2,000-tonne galvanised metal silo with its rings assembled and the roof railing installed

How a metal silo is assembled: ring by ring

A metal silo is not raised in one piece. It goes up ring by ring, in corrugated galvanised sheet, bolted according to the manufacturer's documentation.

We check verticality on every ring as the structure grows, not at the end. A small deviation at the base is amplified by height, and if you find it once the cell is finished, you are dismantling rather than correcting. Joints are tightened to the torque specified in the design.

The photographs show the chain hoists and the lifting straps used to position the courses — controlled lifting rather than reaching for the crane at every move. The telescopic crane comes in for the large pieces and for the roof.

It is the same method we use for mechanical assembly of grain silos, whatever is stored inside them.

Roof, walkways and safe access

The conical roof goes over the body of the cell, followed by the railing ring, the central platform and the access stairs between silos.

This part is not decoration. A silo is inspected, cleaned and maintained throughout its working life, and whoever climbs up there needs to reach the inspection hatch, the sensors and the ventilation safely. Railings, platform and stairs are part of the job from the outset, not something added afterwards.

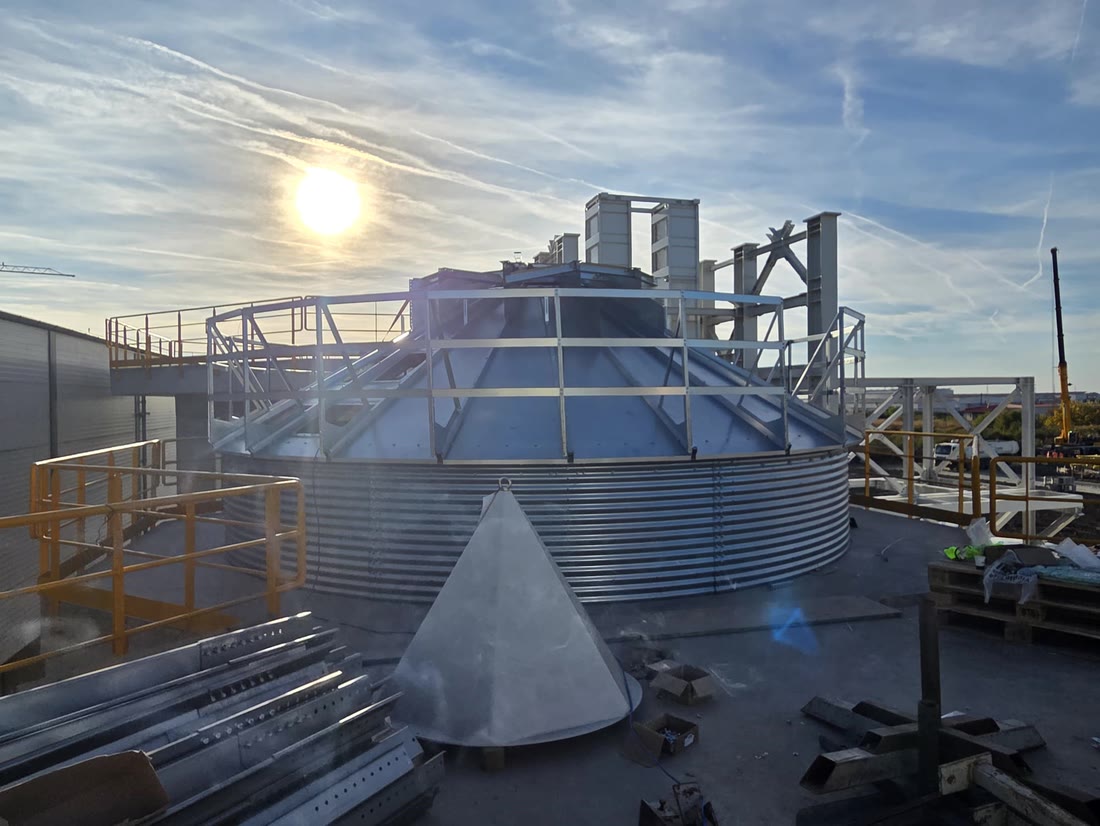

Conical roof of the pellet silo under assembly, with railing and access platform, at Biotim Timișoara

Mechanical assembly on a site working in parallel

The site does not wait for us. The elevator towers and transport galleries are already up and painted, other crews are working in parallel, and crane access has to be negotiated around everything else going on.

That takes daily coordination: who lifts, when, along which route, and what stays clear for everyone else. On a site this size, planning the lifts matters as much as the assembly itself.

What comes next

Once the cells are closed, the connections to the feed and discharge conveyors follow, with levels verified, then the trials and mechanical commissioning.

We will report back on this one too, as the work moves on.

Do you need mechanical silo assembly on your own site, for grain or for biomass? Get in touch and we will come back with a proposal.

More work

Similar projects

mechanical assembly

Brăila · 36,000 t

The 36,000-ton Project in Brăila Nears Completion

We are nearing the final stage of installation for the 36,000-ton project in Brăila County, a large-scale agricultural facility that includes a complete…

Mechanical assembly

Făurei, Brăila county · 36,000 t

36,000-Ton Project in Faurei, Braila – A New Benchmark in Mechanical Assembly of Metal Silos

In Faurei, Braila County, Rosilo successfully completed one of its most ambitious projects to date – a fully integrated grain storage and processing facility…

mechanical assembly

Romania · 5,000 t · Aber

Start grain storage project with a capacity of 5,000 tons with Aber Hungary technology

With a strong focus on mechanical assembly, Rosilo has initiated a captivating project: the installation of a medium-sized grain storage system, but with…

Request a quote

A job like this one, at your site?

Tell us where the site is, what has to be done and the dates you are working to. We look at what the project needs, work out the resources and come back quickly with a clear proposal.

At home and abroad

Crews available for work in Romania and internationally.
